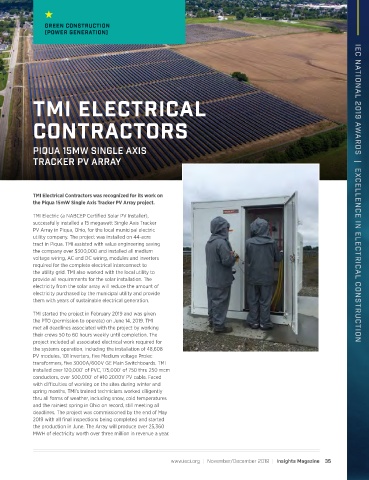

GREEN CONSTRUCTION
                (POWER GENERATION)












            TMI ELECTRICAL


            CONTRACTORS




            PIQUA 15MW SINGLE AXIS
            TRACKER PV ARRAY





            TMI Electrical Contractors was recognized for its work on                                                IEC NATIONAL 2019 AWARDS  |  EXCELLENCE IN ELECTRICAL CONSTRUCTION
            the Piqua 15mW Single Axis Tracker PV Array project.
            TMI Electric (a NABCEP Certified Solar PV Installer),
            successfully installed a 15 megawatt Single Axis Tracker
            PV Array in Piqua, Ohio, for the local municipal electric
            utility company. The project was installed on 44-acre
            tract in Piqua. TMI assisted with value engineering saving
            the company over $300,000 and installed all medium
            voltage wiring, AC and DC wiring, modules and inverters
            required for the complete electrical interconnect to
            the utility grid. TMI also worked with the local utility to
            provide all requirements for the solar installation. The
            electricity from the solar array will reduce the amount of
            electricity purchased by the municipal utility and provide
            them with years of sustainable electrical generation.
            TMI started the project in February 2019 and was given
            the PTO (permission to operate) on June 14, 2019. TMI
            met all deadlines associated with the project by working
            their crews 50 to 60 hours weekly until completion. The
            project included all associated electrical work required for
            the systems operation, including the installation of 48,608
            PV modules, 101 inverters, five Medium voltage Prolec
            transformers, five 3000A/600V GE Main Switchboards. TMI
            installed over 120,000’ of PVC, 175,000’ of 750 thru 250 mcm
            conductors, over 500,000’ of #10 2000V PV cable. Faced
            with difficulties of working on the sites during winter and
            spring months, TMI’s trained technicians worked diligently
            thru all forms of weather, including snow, cold temperatures
            and the rainiest spring in Ohio on record, still meeting all
            deadlines. The project was commissioned by the end of May
            2019 with all final inspections being completed and started
            the production in June. The Array will produce over 25,360
            MWH of electricity worth over three million in revenue a year.



                                                         www.ieci.org  |  November/December 2019  |  Insights Magazine  35
